![]() | Office of the Fire Marshal Plan Review Metrics September 2026 | |||
Review Type

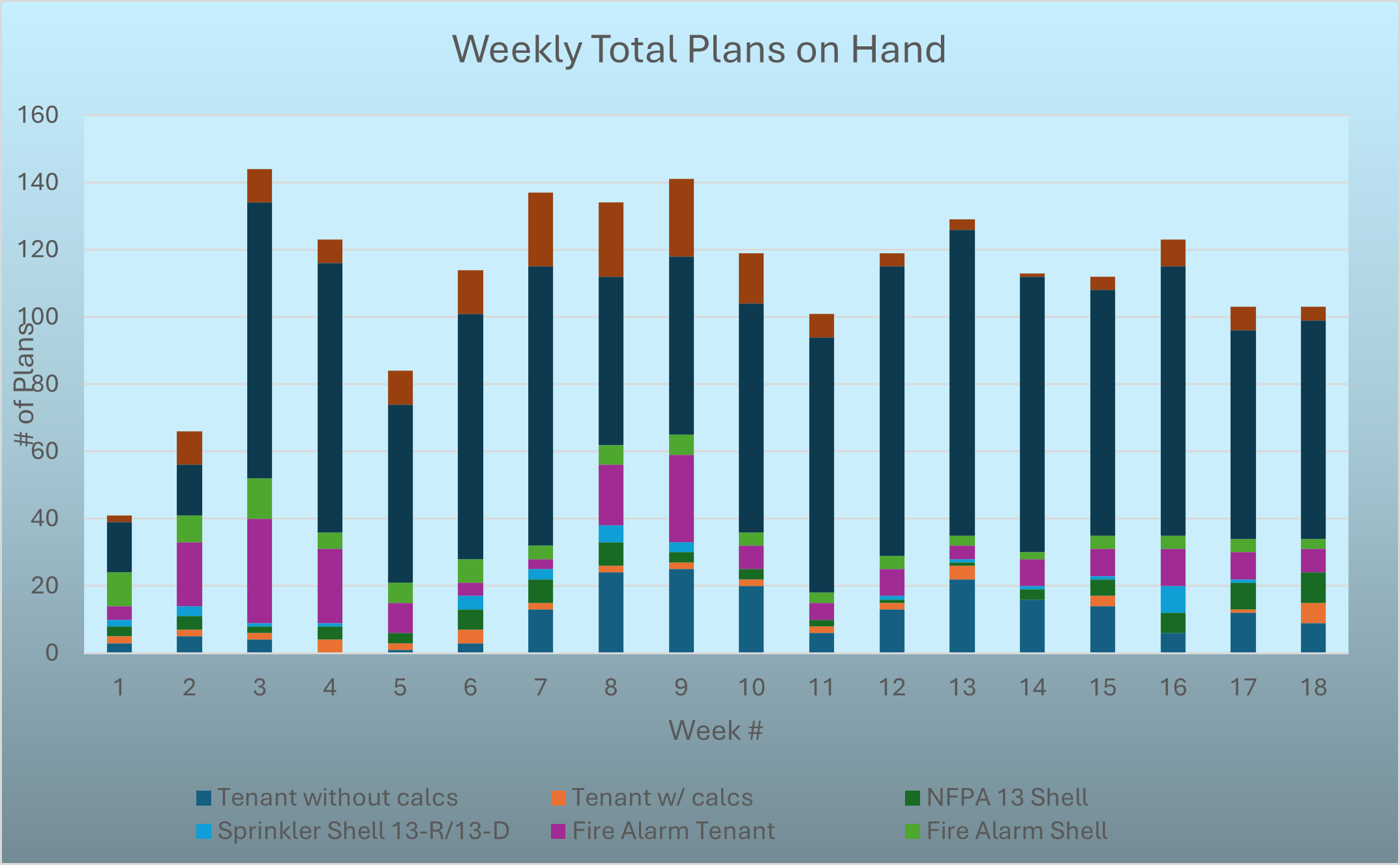

| Total Plans On Hand (Average) | Weekly Average Queue Days | Monthly Average Queue Days | 3-Month Rolling Average Queue Days |

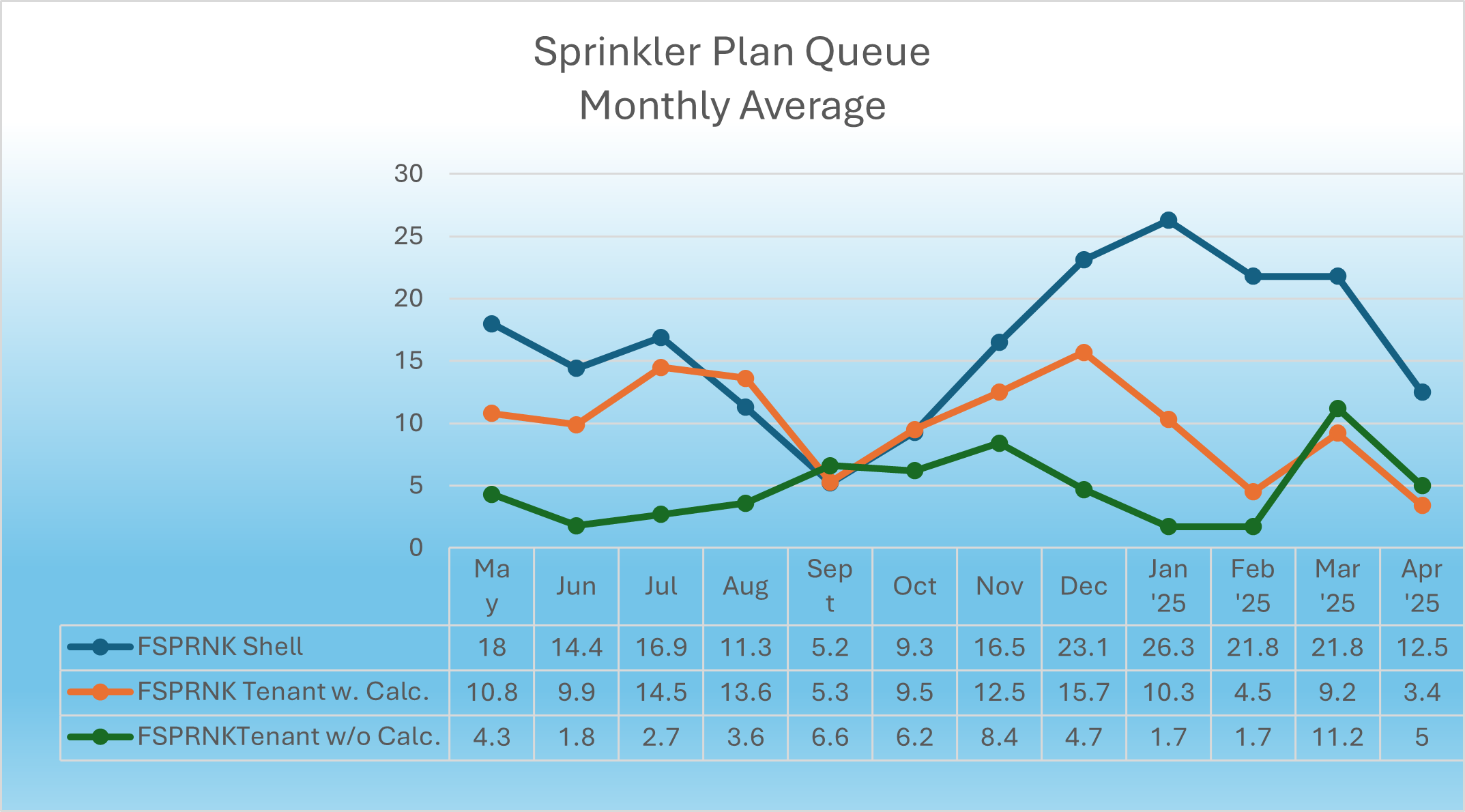

Sprinkler Review | ||||
| Shell | 1.3 | 5.3 | 11.4 | 17.1 |
| Tenant with calculations | 2.8 | 8.0 | 10.4 | 20.1 |
| Tenant w/out calculations | 9.8 | 7.0 | 5.1 | 5.1 |

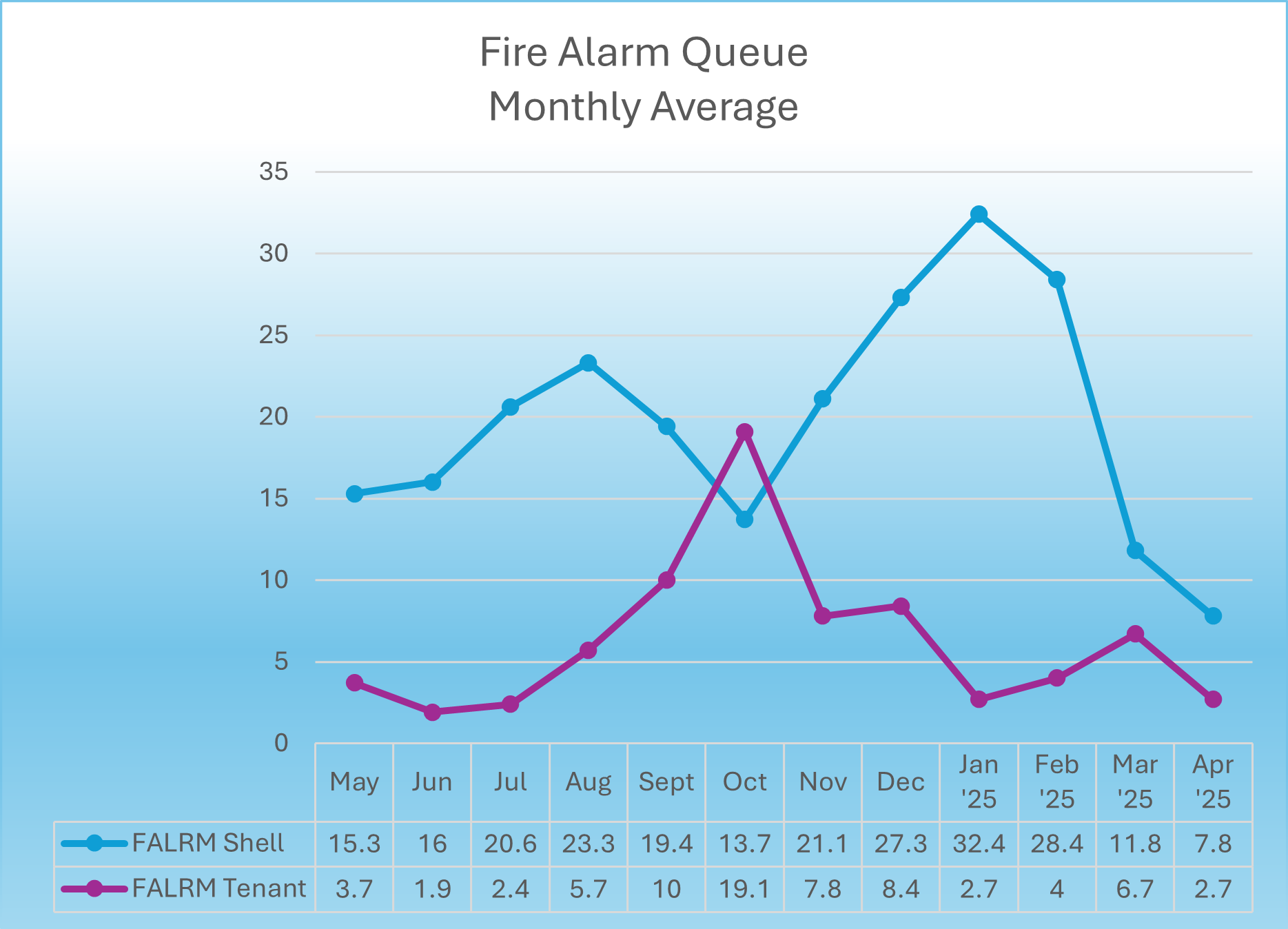

Fire Alarm Review | ||||
| Shell | 5.5 | 25.8 | 23.9 | 23.0 |
| Tenant | 9.8 | 14.8 | 16.2 | 23.1 |

Architectural Review | ||||
| Class 4 or greater | 21.0 | 24.8 | 29.7 | 30.1 |
| Site Plans | 14.5 | 10.3 | 11.0 | 12.9 |
