Public Works and Environmental Services Alert:

Pipe installation under Little Hunting Creek was paused in June 2025 after two failed drilling attempts using Horizontal Directional Drilling (HDD). The drill could not be completed safely due to the unstable soil under the creek.
Since June 2025, the project team worked with HDD experts to understand what went wrong and to redesign the bore and drilling approach. Construction resumed in February 2026 with new design.
We recognize that the construction, drilling issues, and extended pause on this project have been disruptive and frustrating. Thank you for your continued patience as we work to complete it by Fall 2026.
We are drilling under Little Hunting Creek using HDD.
Right now, we are in the “reaming” phase. This means we are slowly and incrementally making the bore larger. The final bore will be about 54 inches wide so it can safely fit the new 36 inch high-density polyethylene (HDPE) pipe.
Pipe pullback (pulling the HDPE pipe through the bore hole) is the most important step of this HDD work. More than 1,000 feet of pipe will be pulled under the creek from the Wessynton Swim & Tennis Club to the Little Hunting Creek Pump Station.
Once pullback starts, crews must keep working until the pipe is all the way through. If the pull stops, we risk the pipe soils under the creek becoming unstable and the pipe getting stuck as it did on the previous attempts.
| Location | What is Happening | What to Expect for HDD Installation |
|---|---|---|
| Little Hunting Creek Pump Station (Thomas J. Stockton Pkwy & Londonderry Rd) | Main HDD entry point, drilling, and mud recycling site | Frequent construction equipment traffic and steady engine noise through May 2026. |
| Wessynton Forest Trail | Pipe storage and preparation | Trail is now closed. For your safety, please stay off the trail. Restoration work will follow HDD completion. |
| Wessynton Swim & Tennis Club | HDD pipe exit point | Limited access, construction traffic, and noise through May 2026, especially during pipe pullback. Restoration work will take place in May. |
| Wessynton Way | Pipe delivery route and pullback support | 04/13/2026 to 04/15/2026: Closed to through-traffic at the Swim & Tennis Club entrance. |
| Mt Vernon Hwy (VA-235) | Pipe pullback support and traffic control | 04/14/2026 & 04/15/2026: Two of the three lanes between Wessynton Way and Cunningham Dr will be closed. The remaining lane will stay open with flaggers directing traffic. Expect slow traffic and short delays. |
| Surrey Dr & Common Area | No HDD drilling work now | Final pipe connection (tie-in) to the existing sewer system planned for August 2026, followed by restoration. |
The Little Hunting Creek Force Main carries wastewater from the Little Hunting Creek Pump Station. This pump station serves the surrounding community and other areas upstream. In 2016, the Fairfax County Department of Public Works and Environmental Services (DPWES) repaired parts of the force main after inspecting its condition. However, due to its age and the inspection results, DPWES decided that the force main needs to be replaced.
A study looked at different ways to replace the old force main. Its location under a tidal creek and through residential areas makes it difficult to use normal construction methods. Here are the challenges:
Out of the nine options evaluated, the one shown below was selected because it:

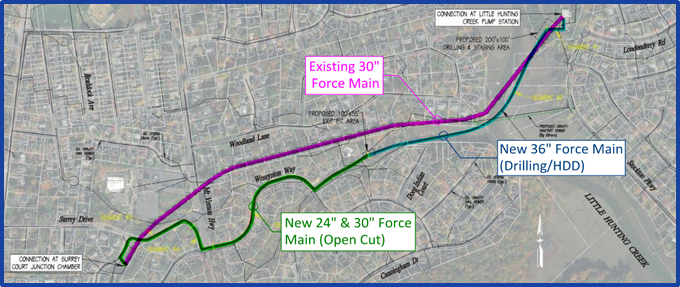

This project will replace 4,560 feet of the existing 30-inch pipe. We will use horizontal directional drilling (HDD) to replace the section under Little Hunting Creek with 30” and 36” pipe. Regular digging, also known as open cut or trenching, will be used to connect it using 30” pipes to the end point near the intersection of Surrey Dr. and Surrey Ct.
The force main is in the Mount Vernon District. It starts at the Little Hunting Creek Pump Station near the intersection of Thomas J. Stockton Pkwy. and Londonderry Rd. on the east side of Little Hunting Creek. The pipe runs westward under Little Hunting Creek and through residential areas. It ends at a junction near the intersection of Surrey Dr. and Surrey Ct.
This project is currently under construction.
Replacing the Little Hunting Creek Force Main will:
The new force main is expected to last for the next 50 years.
DPWES staff and consultants will closely supervise all the work, including the HDD creek crossing, to make sure it is done right. We will do our best to keep noise and disruptions to a minimum in your neighborhood and plan construction to avoid interfering with your recreational activities. You can rest assured that your sewer service will continue without any interruptions.
The Little Hunting Creek Force Main Project will cost $13.6 million to construct, which will be provided by Fairfax County’s Capital Improvement Program. This program supports important wastewater and infrastructure projects like this one.
Access information shared about this project at previous community meetings through the links below and the FAQ:
A meeting was held on Friday, 12/13/2024, to present more about the project and answer any questions you may have.
Learn more about the drilling process to be used by watching this video:
For more information, please contact Katherine Ovalle La Torre from DPWES.
Email: Katherine.OvalleLaTorre@fairfaxcounty.gov
Phone: 703-324-5111, TTY 711
